If the honest answer is “not exactly,” your books are hiding it. Job costs in the wrong accounts, a WIP schedule nobody trusts, cash that vanishes between draws. We go through your books and the construction software feeding them, on job costing, margins, WIP, and cash flow. You get a complete, detailed report in 48 hours.
Commercial GCs run 15% to 30%. A 52.8% margin does not mean a great year. It means costs are sitting in the wrong place.
From a real 48-hour audit. Client details removed.
Works with the tools you already run
QuickBooks
Procore
Buildertrend
JobTread
Knowify
ServiceTitan
Jobber
Housecall Pro
Sage
Gusto
Six things we take apart, line by line, before we write a word of the report.
Most contractor files run on the generic setup QuickBooks ships with, built for a shop, not a jobsite. We find the duplicate accounts, the buckets that mean nothing, and the job costs sitting where no report will ever look for them.
Procore, Buildertrend, Knowify, JobTread, ServiceTitan. We check line by line what actually reaches your accounting and what quietly falls through. A job can read “Synced” and still be missing six figures of cost.
Whether every dollar of labor, material, and sub cost lands on the job that caused it, or gets swept into one pile at the end of the month. If it does not, you cannot say which jobs pay you and which ones you are financing.
Your real gross margin against what your kind of work should actually run. A margin that looks too good is not a good year. It almost always means costs are parked in the wrong place.
The split almost every contractor gets wrong. Job costs booked as operating expense make gross profit look strong and hide the jobs that lost money. We put every cost back on the right side of the line.
Whether your WIP schedule, retainage, and balance sheet would survive a surety or a bank asking to see them. Most would not, and owners tend to find that out the week they need the bond.
Actual pages out of the reports contractors got from us. Client details removed, numbers untouched.
One recent audit uncovered
in job costs missing from a project that showed as “Synced” in QuickBooks. Hidden in plain sight until the audit pulled it out.

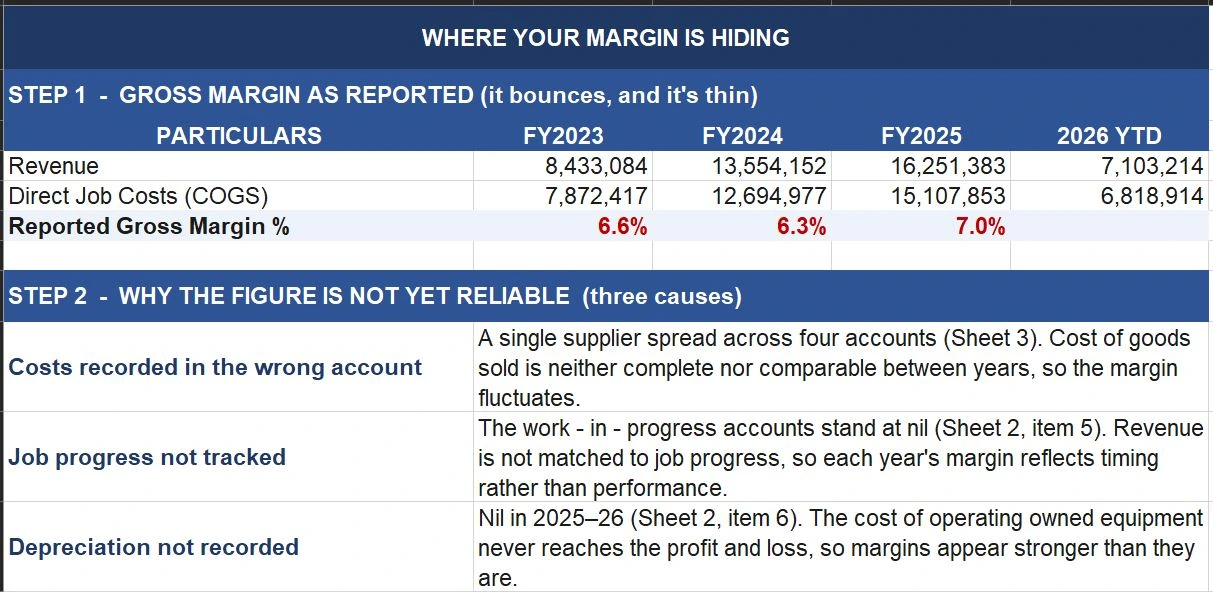

Thin, and bouncing year to year. The audit page names all three reasons the number could not be trusted: costs in the wrong account, job progress never tracked, depreciation never recorded.

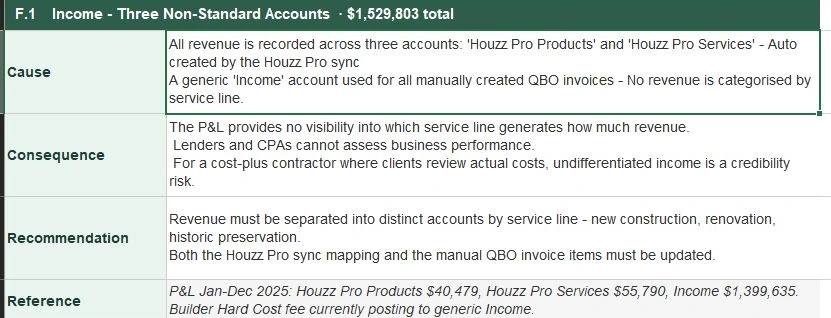

No jargon and no vague warnings. This one traces $1.5M of revenue sitting in three accounts that describe nothing, and states exactly how it gets split by service line.

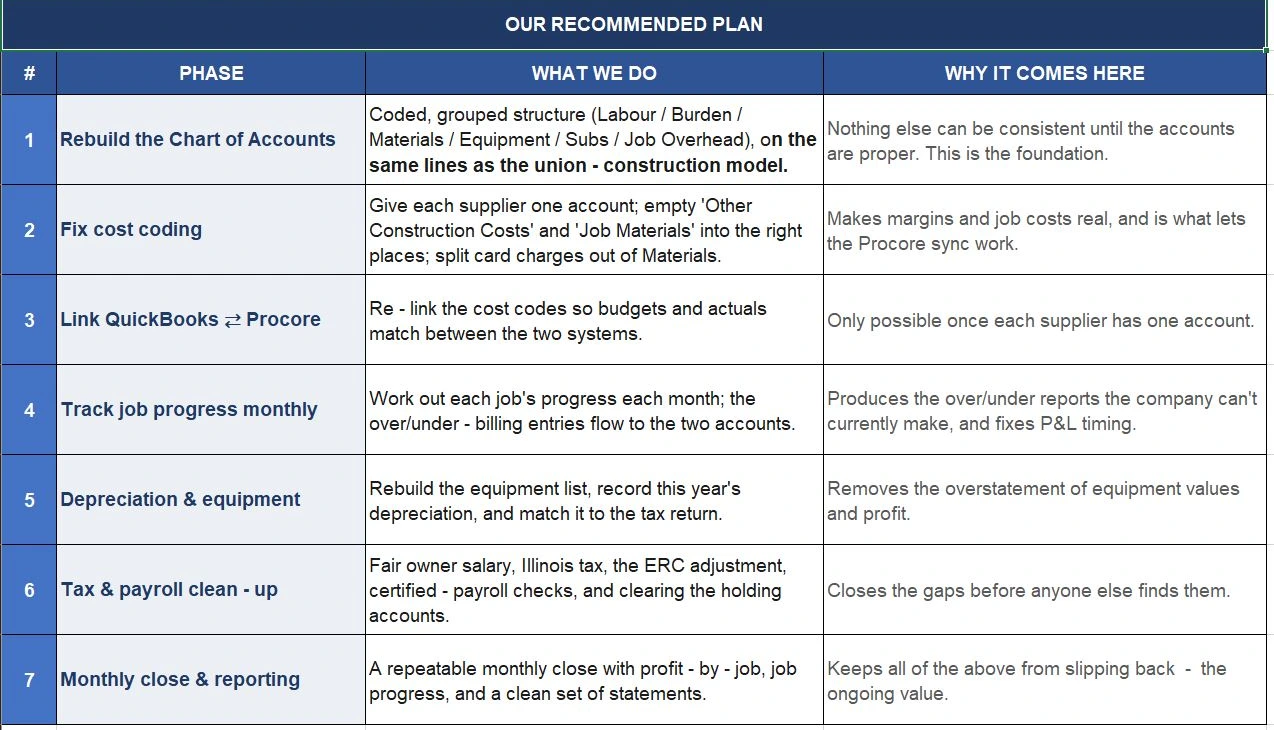

The report ends with the plan: rebuild the chart of accounts, fix cost coding, link QuickBooks to Procore, track job progress monthly. Yours to run with, whoever does the work.
Real pages from delivered audits. Client and project details removed.
Every one of these came out of a free 48-hour audit. Client details removed.
Two overlapping charts of accounts running at once. The same cost could post to either set, so no account held the full amount and gross margin could not be trusted.
WIP accounts frozen at identical balances across two years. No WIP was computed, so profit was overstated and the surety schedule was out of date.
Billings in excess of cost booked as income and as a liability, at different amounts. Revenue and profit both overstated.
A Retainage Payable balance that had not moved in three years. A carried-forward plug hiding payables the contractor still owed.
$174K of cash consumed in a year the books showed a profit. Receivables-driven, and masked by the bank balance.
Revenue split across Sales, Income, and Uncategorized Income. No way to see which stream actually made money.
Every one of these was written up the way you saw above: what caused it, what it costs you, and how it gets fixed.
Each of these contractors came in on a free audit, read what we found, and kept us on monthly. Their books today, against the books we walked into.
Free audit of your books and the construction software feeding them. Job costing, margins, WIP, cash flow. A complete, detailed report in 48 hours.
